Many construction teams in Birmingham Alabama assume that shallow foundations on the Piedmont residual soils will behave uniformly across the site. That assumption often leads to differential settlement when variable clay layers or ancient streambeds go undetected. A properly designed preloading with surcharge system addresses this by applying a temporary load that exceeds the final service load, forcing consolidation before structural elements are placed. The approach works especially well when combined with vertical drains to accelerate pore pressure dissipation in low-permeability strata. Without this staged loading, the risk of long-term settlement remains embedded in the foundation soils.
Preloading with surcharge design staged fills to exceed final loads, forcing consolidation before structural elements are placed and eliminating future settlement surprises.
Methodology and scope
A typical project near the Cahaba River floodplain involved a 15,000-square-foot warehouse where the top 20 feet consisted of soft clay underlain by weathered phyllite. The design called for a surcharge fill 4 feet higher than the final slab elevation, left in place for 90 days. Settlement plates and piezometers tracked the consolidation rate weekly. The preloading with surcharge design used a factor of safety of 1.3 against bearing failure during the surcharge phase, following ASCE 7 load combinations. Field data showed 88% of primary consolidation completed within the planned window, allowing the surcharge to be removed and the structural slab built on a pre-compressed subgrade. The same logic applies to embankments along I-65 corridors where soft ground extends laterally.
Technical reference image — Birmingham Alabama
Local considerations
In Birmingham Alabama, many sites have a thin crust of stiff clay underlain by softer material. Contractors often underestimate how much that lower zone will settle once the building weight is applied. Without a preloading with surcharge design, the differential settlement between the building core and the edge can crack floor slabs and misalign tilt-up panels. The risk is highest along Valley Creek and the Black Warrior River terraces, where alluvial deposits exceed 30 feet in thickness. A staged surcharge program with proper geotechnical instrumentation prevents those failures by confirming that the ground has reached the required stiffness before construction continues.
Laboratory oedometer tests (ASTM D2435) on undisturbed samples to determine preconsolidation pressure, compression index, and coefficient of consolidation. These parameters drive the surcharge height and duration calculations.
02
Surcharge Fill Design and Staging Plan
Development of staged fill sequences with specified lift thicknesses, waiting periods, and surcharge heights based on target post-construction settlement criteria. Includes stability checks against base failure.
03

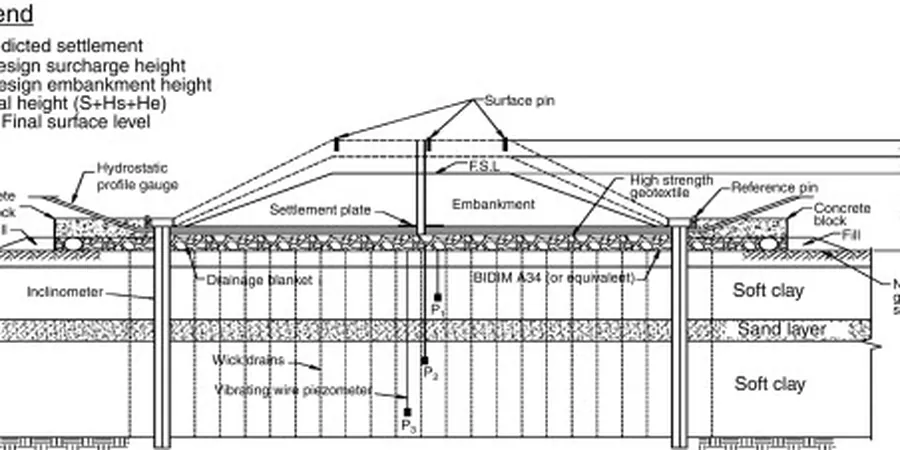

Field Instrumentation and Monitoring
Installation of settlement plates, vibrating-wire piezometers, and inclinometers to track real-time consolidation progress. Data is reviewed weekly to adjust the schedule or surcharge height as needed.
Applicable standards
ASCE 7-22 – Minimum Design Loads for Buildings (surcharge load combinations), ASTM D2435 – Standard Test Methods for One-Dimensional Consolidation Properties of Soils, FHWA NHI-05-037 – Ground Improvement Methods (surcharge and preloading chapter), IBC 2021 – Chapter 18, Section 1803 – Foundation and Geotechnical Investigations
Frequently asked questions
How long does preloading with surcharge typically take in Birmingham Alabama clay soils?
For the Piedmont residual clays common in Birmingham Alabama, primary consolidation usually completes within 60 to 120 days under a properly designed surcharge. Sites with higher silt content or pre-existing drainage layers can finish faster, while thick alluvial deposits may require 150 days or more. The timeline is confirmed through field settlement monitoring, not assumed from lab data alone.
What is the difference between preloading and surcharging in geotechnical practice?
Preloading refers to applying a temporary load equal to the final design load to pre-compress the soil. Surcharging uses a load greater than the final design load to accelerate consolidation and reduce post-construction settlement further. In the preloading with surcharge design approach, the surcharge is the extra height above the final grade that drives faster pore pressure dissipation.
Can preloading with surcharge be combined with vertical drains in low-permeability soils?
Yes. When the clay layer has a coefficient of consolidation below 10 ft²/year, vertical drains (wick drains or sand drains) are installed to shorten the drainage path. The combination reduces the consolidation time from years to months. The preloading with surcharge design then works in tandem with the drains to achieve the required degree of consolidation within the construction schedule.
What is the typical cost range for a preloading with surcharge design study in Birmingham Alabama?
A comprehensive design study including consolidation testing, analysis, and monitoring plan preparation typically ranges between US$880 and US$2,650 for a single project area. This does not include field instrumentation installation or surcharge fill materials. Costs vary with the number of soil borings, lab tests, and monitoring duration required.
